Road Program 2023- Part 2 (Updated 9/21/2023)

At the July 18th Board of Supervisors Meeting, the 2023 Road Program Part 2 Base and Alternates List of Roads were given authorization to go out to bid.  At the Special Board Meeting on August 30th, the Board of Supervisors awarded the Road Program 2023 Part 2 (Base and Alternates) to James D. Morrissey in the amount of $2,829,969.05.

Work is anticipated to begin the week of 10/2/23.

Here is the tentative schedule for road paving for the next two weeks:

  • New Road: Mill-10/2 Pave-10/6
  • Stringer Drive: Mill-10/2 Pave-10/9
  • Saddle Drive: Mill-10/3 Pave-10/10 & 10/11
  • Bridle Drive: Mill-10/4 Pave-10/11 & 10/12
  • Turkey Lane 3"Binder: Mill-10/5 Pave-10/5
  • Farm House Lane 3" Binder: Mill-10/5 Pave-10/5
  • Pebble Hill Road: Mill-10/6 & 10/9 Pave-10/13 &10/16

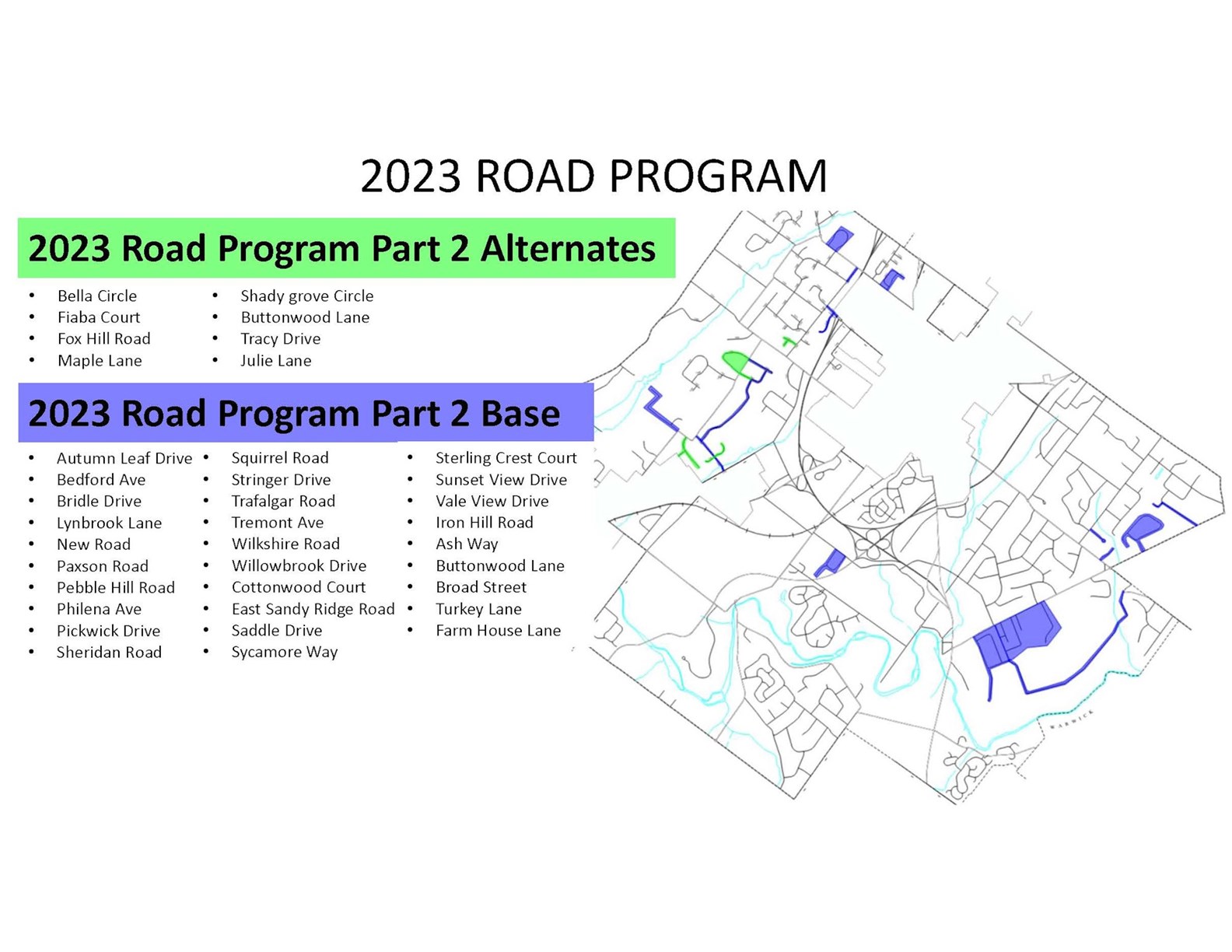

Below is the list of roads including in the Part 2 Base and the Part 2 Alternates:

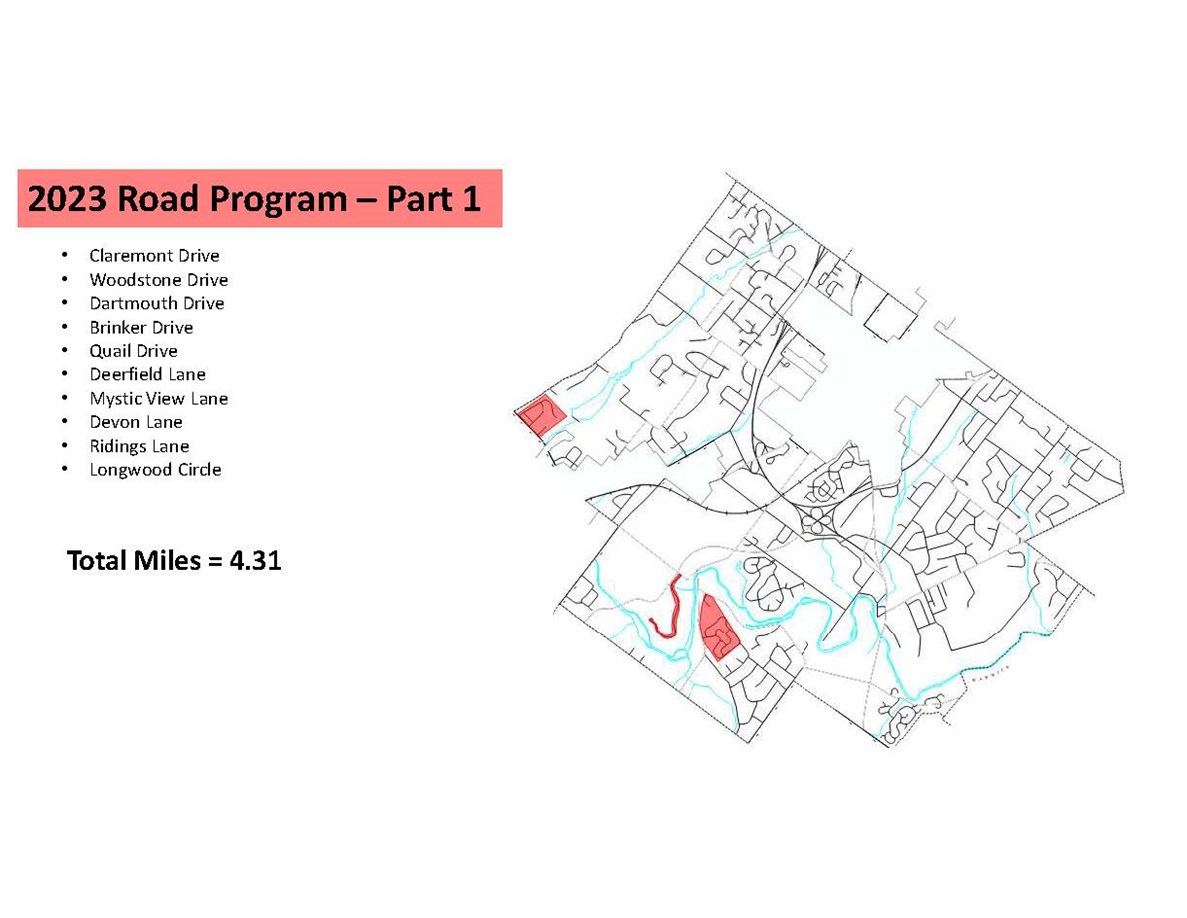

Road Program 2023- Part 1 (Completed)

At the March 21st Board of Supervisors Meeting, the 2023 Road Program Part 1 Project was authorized to go out to bid on the project. At the April 18th Board Meeting, the Supervisors awarded the bid to James D. Morrissey, Inc. in the amount of $927,119.20 for Part 1 of 2023 Road Program.
