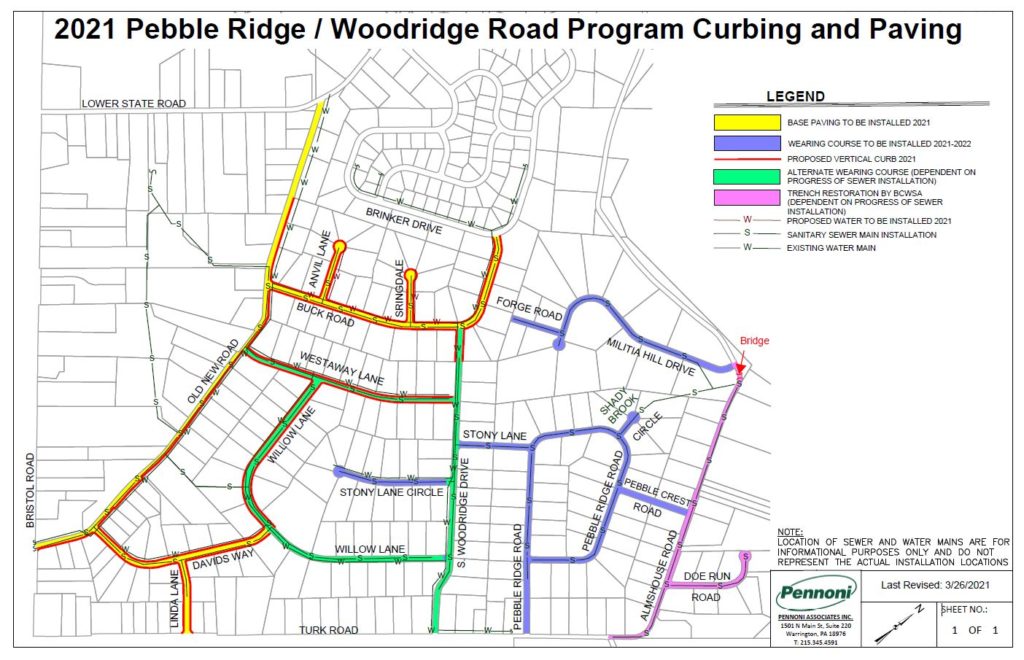

Road Program: Paving and Curbing Projects

9/10/2021

Week of 9/13/2021 – Construction Stake-out (Survey) of new curb will continue on:

  • Woodrigde Drive
  • Buck Road
  • Springdale Road, and
  • Old New Road

Survey stake-out will include the placement of wood survey stakes approximately every 50’ or less, 5’ behind the exiting edge of the combination curb and gutter within the existing roadway right-of-way. Residents are requested not to remove or disturb the survey stakes, as replacing them will add delay and cost to the project.

As of Friday 9/10, Reasmstown Excavating and their subcontractors will have completed the removal and installation of curbing on Willow Lane and Westaway Lane, totaling approximately 6,600 lineal feet (1.25 miles). Reamstown will move to the intersection of Woodridge Drive and Buck Road, then to Buck Road, and Springdale Road

  • The exiting combination curb and gutter will be removed in front of their property and there will be open trenches at times. The curb and gutter in front of their driveway will be removed and temporarily replaced with stone.
  • Access to residential driveways will be restricted temporarily during the day (when work is in being done in front of their property), however access will be restored as soon as the demolition/removal is complete.
  • When the new curbing is installed, access will be restricted to residential driveways for a day or two while the concrete sets.
  • Driveway grades will be adjusted as needed to meet the new curb elevation. Maximum length of driveway adjustment is anticipated not to exceed 20 feet from the curbline into the properties, and may be less in most cases.
  • Contractors will be allowed to store equipment and material within the existing road right-of-way, which includes in the roadway and/or the grass area immediately behind the exiting curb and within public right-of-way. All grass areas that are disturbed during construction will be graded, top soiled and seeded.

8/9/2021

2021 Road Program – Curbing – Project Schedule and Scope of Work

  • Notice to Proceed to Contractor – 8/5/2021
  • Construction Stake-out (Survey) of new curb – week of 8/9/2021
  • Start of Work – 8/17/2021 – Curb removal

Week of 8/9/2021 – Construction Stake-out (Survey) of new curb
Surveyors will start survey stake-out for the curbing project on the following roads.

  • Willow Lane
  • Westaway Lane

Survey stake-out will include the placement of wood survey stakes approximately every 50’ or less, 5’ behind the exiting edge of the combination curb and gutter within the existing roadway right-of-way. Residents are requested not to remove or disturb the survey stakes, as replacing them will add delay and cost to the project.

Week of 8/16/2021 – Start of Construction
Reamstown Excavating and Concrete will mobilize on site to starting on Willow Lane, working to toward and move to Westaway Lane.

  • The exiting combination curb and gutter will be removed in front of their property and there will be open trenches at times. The curb and gutter in front of their driveway will be removed and temporarily replaced with stone.
  • Access to residential driveways will be restricted temporarily during the day (when work is in being done in front of their property), however access will be restored as soon as the demolition/removal is complete.
  • When the new curbing is installed, access will be restricted to residential driveways for a day or two while the concrete sets.
  • Driveway grades will be adjusted as needed to meet the new curb elevation. Maximum length of driveway adjustment is anticipated not to exceed 20 feet from the curb line into the properties, and may be less in most cases.
  • Contractors will be allowed to store equipment and material within the existing road right-of-way, which includes in the roadway and/or the grass area immediately behind the exiting curb and within public right-of-way. All grass areas that are disturbed during construction will be graded, top soiled and seeded.

6/11/2021

James D. Morrissey, Inc. is planning to continue milling and base paving on the following dates and roads next week, June 14 through June 16.

  • Monday June 14th: Finish (delayed due to weather) Old New Road (3” Mill & 3” 19 MM Asphalt Replacement)
  • Monday June 14th : Pebble Ridge Road (1-1/2” Asphalt Overlay)
  • Tuesday June 15th : Pebble Crest Road/ Pebble Ridge (1-1/2” Asphalt Overlay)
  • Tuesday June 15th : Road/Shady Brook Circle (1-1/2” Asphalt Overlay)
  • Wednesday June 16th : Stony Lane/ Stony Lane Circle (1-1/2” Asphalt Overlay)

Curb Replacement Update
On Tuesday June 8, 2021 bids were opened for the Curb Replacement project. A recommendation for award will be presented to the Board of Supervisors (BOS) on Tuesday June 15, 2021 at the 7:00 PM BOS Meeting. Upon approval by the BOS, a notice of award will be issued to the contractor.

6/4/2021

James D. Morrissey, Inc. is planning to start milling and base paving on the following dates and roads next week, June 9 through June 11.

  • Wednesday June 9th: Old New Road (3” Mill & 3” 19 MM Asphalt Replacement)
  • Thursday June 10th: Old New Road/Buck Road (3” Mill & 3” 19 MM Asphalt Replacement)
  • Friday June 11th : Springdale Road/Buck Road (3” Mill & 3” 19 MM Asphalt Replacement)

5/7/2021

2021 Road Program – Paving
On Tuesday 4/27, five bids were received the 2021 PRWR Road Program – Paving contract. On Tuesday, 5/4, the Board of Supervisors accepted the recommendation of the Township Engineer to award the road paving program to James D. Morrissey, Inc. (JDM). Notice of award was sent to JDM on 5/6. Upon execution of by the contract documents, a notice to proceed will be issued to the contractor.

2021 Road Program – Curbing
On 4/27 the 2021 Road Program – Curbing contract was advertised for public bidding. The bids for the curing contract are due on 6/8. Upon review of the received bids an award recommendation will be made to the Board of Supervisor on 6/15.

2020 Road Program – Curbing follow-up restoration
An inspection was conducted along the roads where vertical curbing was installed in 2020 to determine where follow-up restoration (topsoil and seeding) is required. A punchlist was generated and issued to the contractor. An update will be posted when a schedule is provided by the contractor.

4/23/2021

2021 Road Programs Paving and Curbing
2021 Road Programs Paving and Curb installation construction projects consist of mill and road base paving, installation of roadway wearing course paving, and removal of the existing combination curb and gutter, and installation of new vertical curbing. Below is the schedule for the projects.

Paving Schedule

  • Bid Opening – 4/27/2021
  • Award Recommendation to Board of Supervisors – 5/4/2021
  • Notice of Award to Contractor – 5/5/2021
  • Notice to Proceed to Contractor – 5/31/2021 (Tentative)
  • Contract Completion – 6/30/2021

Curbing Schedule:

  • Bid Opening – 6/8/2021
  • Award Recommendation to Board of Supervisors – 6/11/2021
  • Notice of Award to Contractor – 6/16/2021 (Tentative)
  • Notice to Proceed to Contractor – TBD
  • Contract Completion – TBD

3/8/2021

Base paving will begin in May of 2021 with finish paving and curbing to follow

12/18/2020

The 2020 Road Program (paving and curbing) have been completed. In January we will begin the process of planning the 2021 curbing and road program for the Pebble Ridge/Woodridge area.

12/4/2020

Curb work is complete except for the crosswalk ramps at Pebble Ridge and Turk Roads. This work is slated for the coming week upon completion of some utility work. In addition, paving will resume on Monday on Willow, Westaway and Stony Lane Circle.

11/13/2020

Curbing

  • finish prepping the remainder of Stony Lane Circle and one side of Willow Lane for a curb pour on Tuesday 11/17/20
  • They will then fall back and continue curb backfilling, topsoiling and prepping driveways
  • Curb ramps at Turk and Pebble Ridge may be prepped and poured as well next week.

Paving

  • Monday Stony Lane and Woodridge from Buck to Stony Lane Circle
  • Tuesday finish Woodridge from Stony Lane Circle to Turk Road
  • Wednesday Willow Lane from Woodridge to Davids Way
  • Thursday Stony Lane Circle

Due to weather conditions the schedule may slide at any point.

11/6/2020

Reamstown Excavating and their subcontractors will continue the installation of curbing on the south side of Woodridge Drive, one side of Stony Lane Circle and one side of Willow Lane. It is anticipated that milling and base paving will start on the week of 11/16 on Pebble Crest Road, Stony Lane, Woodridge Drive, Stony Lane Circle and Willow Lane. Reamstown Excavating and their subcontractors will continue with the installation of the curbing along the other sides of Stony Lane Circle and one side of Willow Lane after the completion of the milling and paving. The paving contractor (James D. Morrissey Inc) will return in early December to mill and base pave Westway Lane after the installation of the water main and services have been completed.

10/29/2020

The north side of Woodridge Drive will be poured early next week, pushed off due to rain. Reamstown will then switch over to the south side of Woodridge to prep that side for a pour most likely the following week. All streets north of Woodridge will have the backfill and topsoil completed next week. Once it is inspected, it will then be hydroseeded.

10/12/2020

Reamstown Excavating and their sub-contractors (Prieto Corporation and Lyons & Hohl Paving) will be completing work on Pebble Ridge Road, Pebble Crest Road, Shady Brook Circle, and possibly Stony Lane. This work includes roadway paving restoration, driveway apron paving and yard restoration (behind curb).

9/24/2020

  • If you have concerns about what is happening with curb replacement, please seek out Gilmore and & Associates, Inc. Staff on-site or a Township Employee on-site. They will coordinate directly with the contractors.
  • Be aware that the excavation of existing curb and preparation for new curb installation will include some level of disturbance of the front yard, driveway, curbside planted beds, and temporary removal of mailbox.
  • Mailboxes will be temporarily placed or temporarily turned until they can be permanently reset.
  • Driveways will be temporarily stoned to provide access until the day that new curbing is installed.
  • Yards will be restored once curbs are backfilled.
  • Driveway transitions will be permanently paved after curbing is fully cured.

9/21/2020

Reasmstown Excavating will mobilize on site to start the removal of the existing combination curb and gutter, prepare the new curb sub-base for Prieto Corporation to bring in a curb machine to install the new curbing.

Residents should be advised of the following:

  • The exiting combination curb and gutter will be removed in front of their property and there will be open trenches at times. The curb and gutter in front of their driveway will be removed and temporarily replaced with stone.
  • Access to residential driveways will be restricted temporarily during the day (when work is in being done in front of their property), however access will be restored as soon as the demolition/removal is complete.
  • When the new curbing is installed, access will be restricted to residential driveways for a day or two while the concrete sets.
  • Driveway grades will be adjusted as needed to meet the new curb elevation. Maximum length of driveway adjustment is anticipated not to exceed 20 feet from the curbline into the properties, and may be less in most cases.
  • Contractors will be allowed to store equipment and material within the existing road right-of-way, which includes in the roadway and/or the grass area immediately behind the exiting curb and within public right-of-way.

9/14/2020

Surveyors will start survey stake-out for the curbing project on the following roads. The surveyor will be in a vehicle identified with their company logo, they will also be wearing florescent survey attire, and they will be following Covid 19 protocols (wearing of masks and staying socially distant from residents).

  • Pebble Crest Road
  • Pebble Ridge Road
  • Shady Brook Circle

Survey stake-out will include the placement of wood survey stakes approximately every 50’ or less, 5’ behind the exiting edge of the combination curb and gutter within the existing roadway right-of-way. Residents are requested not to remove or disturb the survey stakes, as replacing them will add delay and cost to the project.
